Wilket Creek Erosion Control Minor Works Project

Toronto and Region Conservation Authority (TRCA) has proposed to undertake remedial erosion control works along Wilket Creek within Windfields Park to provide long-term protection to private and public property from the hazards of erosion.

Project Location

The project area is located within Windfields Park below Tudor Gate, near the intersection of York Mills Road and Bayview Avenue.

Learn More About the Project

Project Background

This site was identified as a priority site to TRCA in 2021. This reach of Wilket Creek experienced significant erosion of the existing revetment during periods of high flow. The existing protective material was displaced, the stream bank was undercut, and material on the stream bank eroded away.

Downstream photo of project area. Source: TRCA, 2022.
Upstream photo of project area. Source: TRCA, 2022.

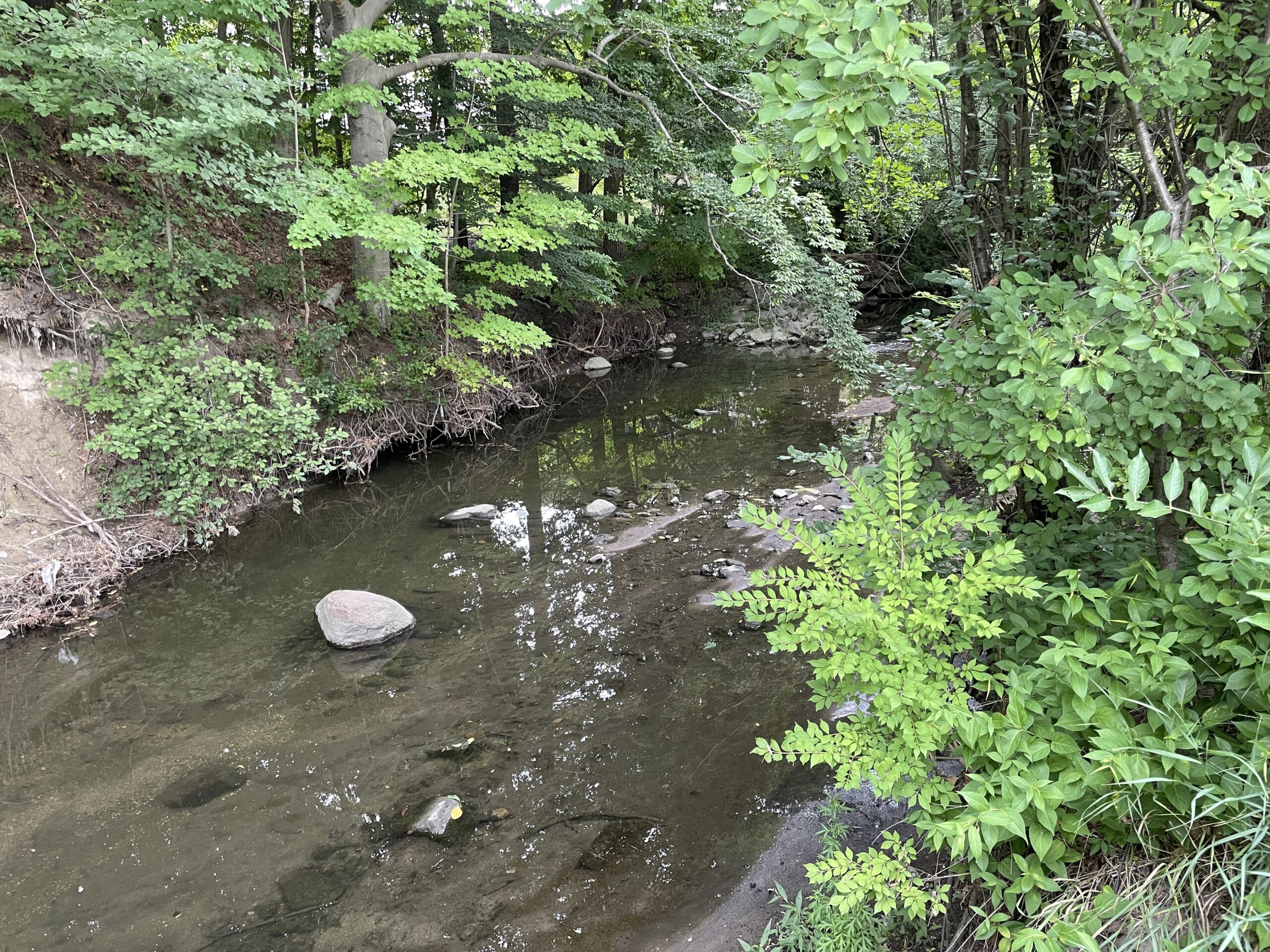

Photo of eroded section of Wilket Creek. Source: TRCA, 2022.

Scope of Work

The proposed scope of work for this project includes completing erosion control works along the banks of Wilket Creek below Tudor Gate to ensure long-term stability and provide protection to infrastructure, private and public property.

Throughout 2024, TRCA intends to:

  • Obtain final detailed designs for the erosion control works
  • Obtain all necessary permits, approvals, and agreements
  • Begin construction in Fall 2024, pending the completion of permits, approvals, agreements, and detailed designs
  • Restore site with native vegetation plantings and trail repairs as required

Construction Information

Construction will begin in October 2024 and will be completed in November 2024. TRCA will update this webpage as construction milestones are completed. Click the link below to view the Notice of Construction that can be found at all site access points:

Tudor Gate – Notice of Construction Sign – Landscape

This notice includes detour routes. But the detour route can also be found here below:



Public Notices

Following completion of planning activities, TRCA will install construction signage to notify trail uses of the trail closures and detour routes. Please see a copy of the Notice of Construction signage showing detour routes below. Originally, TRCA and City of Toronto staff planned to re-open the trail after work hours, but upon further discussion it was determined that due to the short length of the project and for the health and safety of the public, it would be best to provide detours around the construction area instead.

Progress Updates

2025

April 22, 2025

  • Though construction is complete, there will be minor trail repairs taking place in the Spring of 2025, when weather permits
  • Please be aware of signage and construction equipment when using the trails during this time

2024

October 25, 2024

  • Native trees and shrubs have been planted as part of the site restoration phase of the project
  • The staging area has been terraseeded
  • R&M Construction has demobilized from site

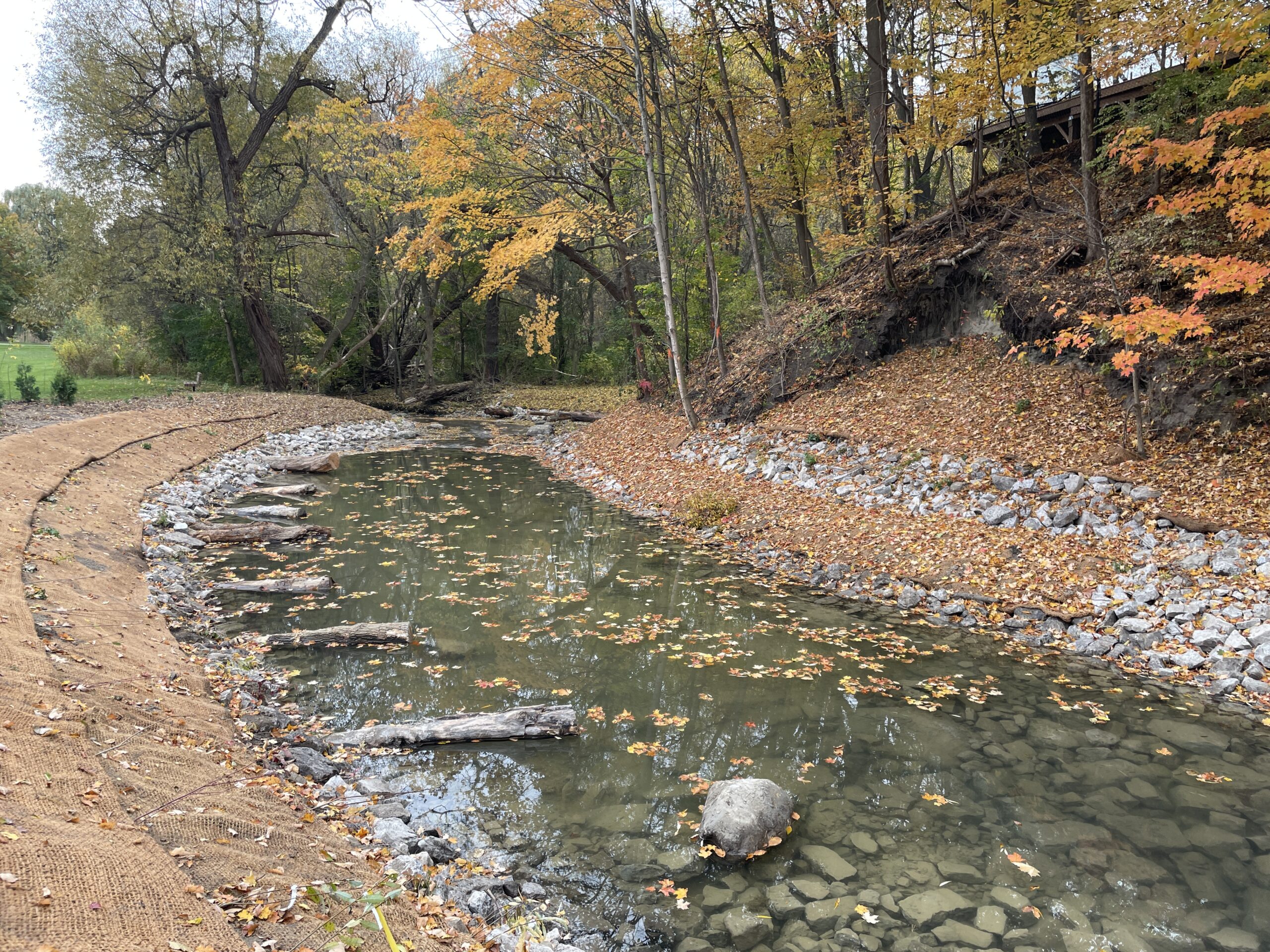

  • The trails are now fully open!

October 22, 2024

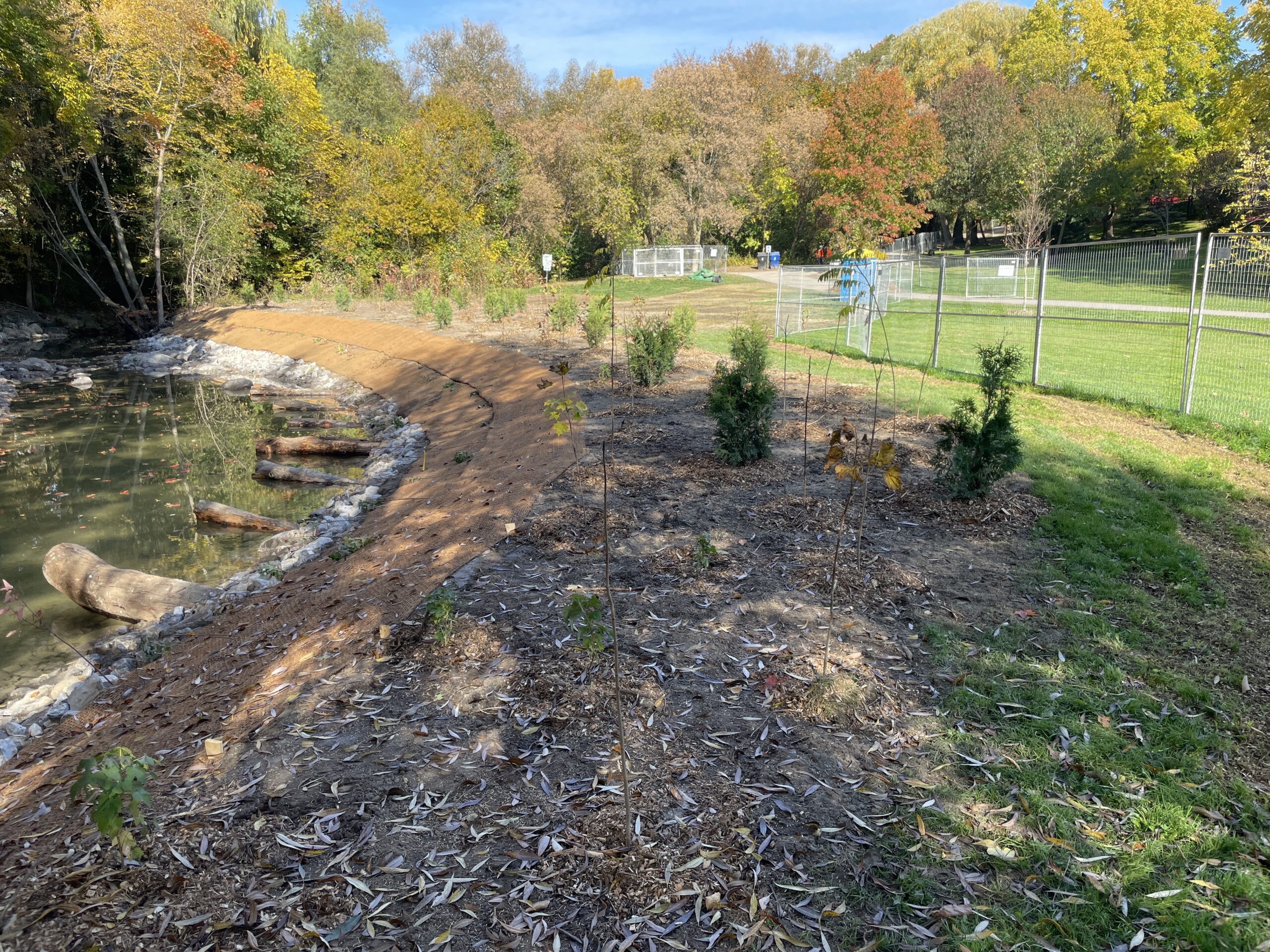

  • Native trees and shrubs have been planted as part of the site restoration phase of the project
  • R&M Construction is demobilizing from site
  • Next steps include terraseeding any damaged lawn areas

October 18, 2024

  • Construction is now complete. Both creek banks have completed vegetated revetments and embedded wood structures installed. The R&M is now moving on to the site restoration phase of the project

October 11, 2024

  • Most of the western stream bank is complete, two weirs are complete, and the two embedded wood structures are complete.

October 9, 2024

  • Site setup complete and work has begun on the in-stream work. So far about 20% of the vegetated revetments are complete as well as one embedded wood structure.

October 1, 2024

  • Site setup has started: site access, staging and stockpiling areas, tree clearing

  • Final detailed designs, permits and approvals obtained
  • Construction firm retained to implement designs – R&M Construction
  • Construction set to begin in October 2024

2023

  • Development of detailed designs

2022

  • TRCA retained Palmer Environmental Consulting Group to develop detailed designs for the long-term maintenance solution for this reach of Wilket Creek

Contact Us

For more information regarding this project, please contact:

Alex Grout, Project Manager
Erosion Risk Management
Restoration & Infrastructure Division
alex.grout@trca.ca
(437) 235-6120
